Read assignment pace and calendar
Use Timeline to answer two different questions without blending them: where teams or students are in the project structure, and where the plan sits on actual calendar dates.
Read progress against the plan

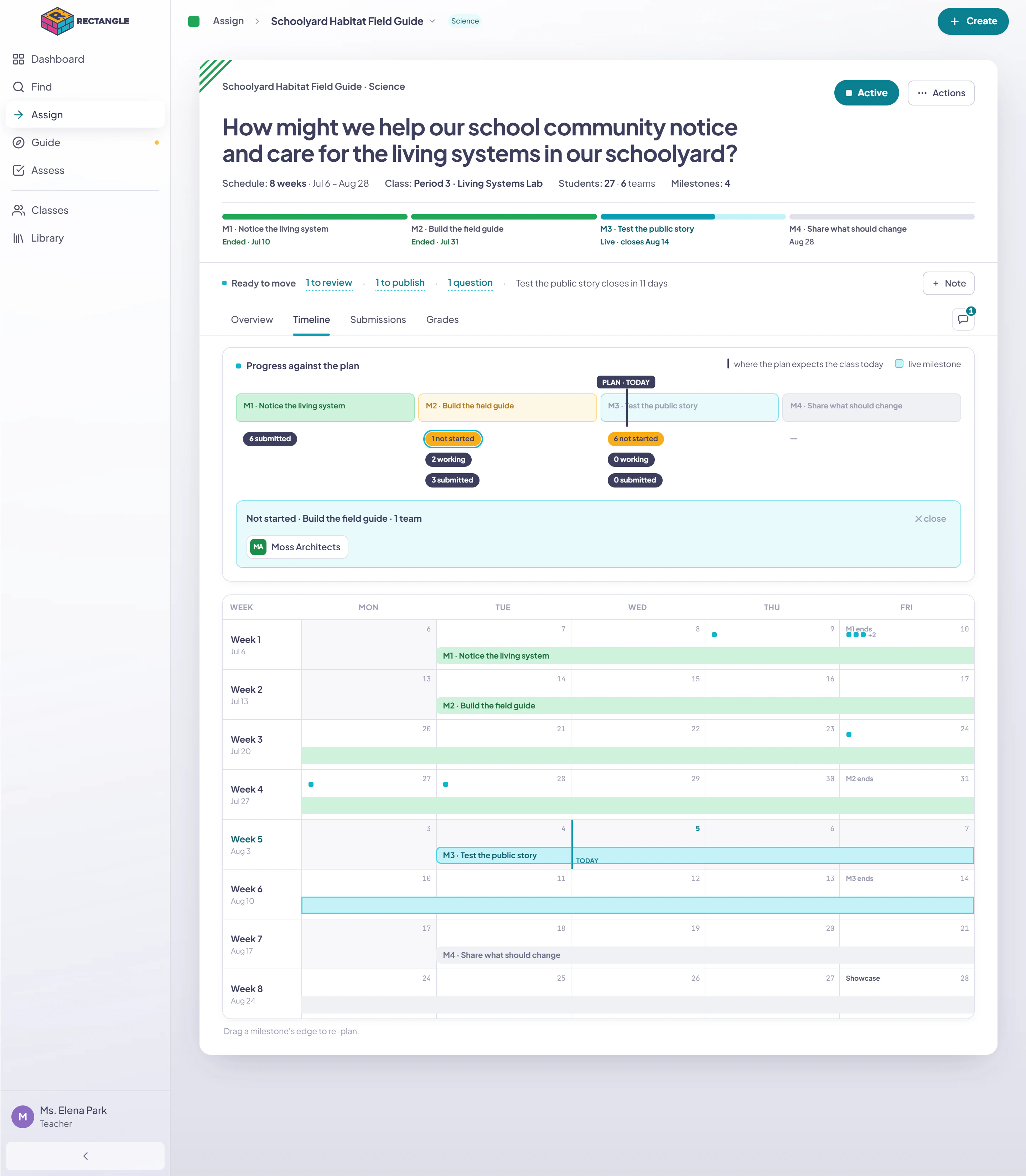

Section titled “Read progress against the plan”The pace strip places the plan’s current point beside counts for not started, working, and submitted work. These are structural states across the project arc; they are not calendar dates or grades.
Select a pace count to reveal the names behind it.
Use the list to decide who needs a closer look. A count is a summary; the named team or student is the actionable evidence.
Read the calendar

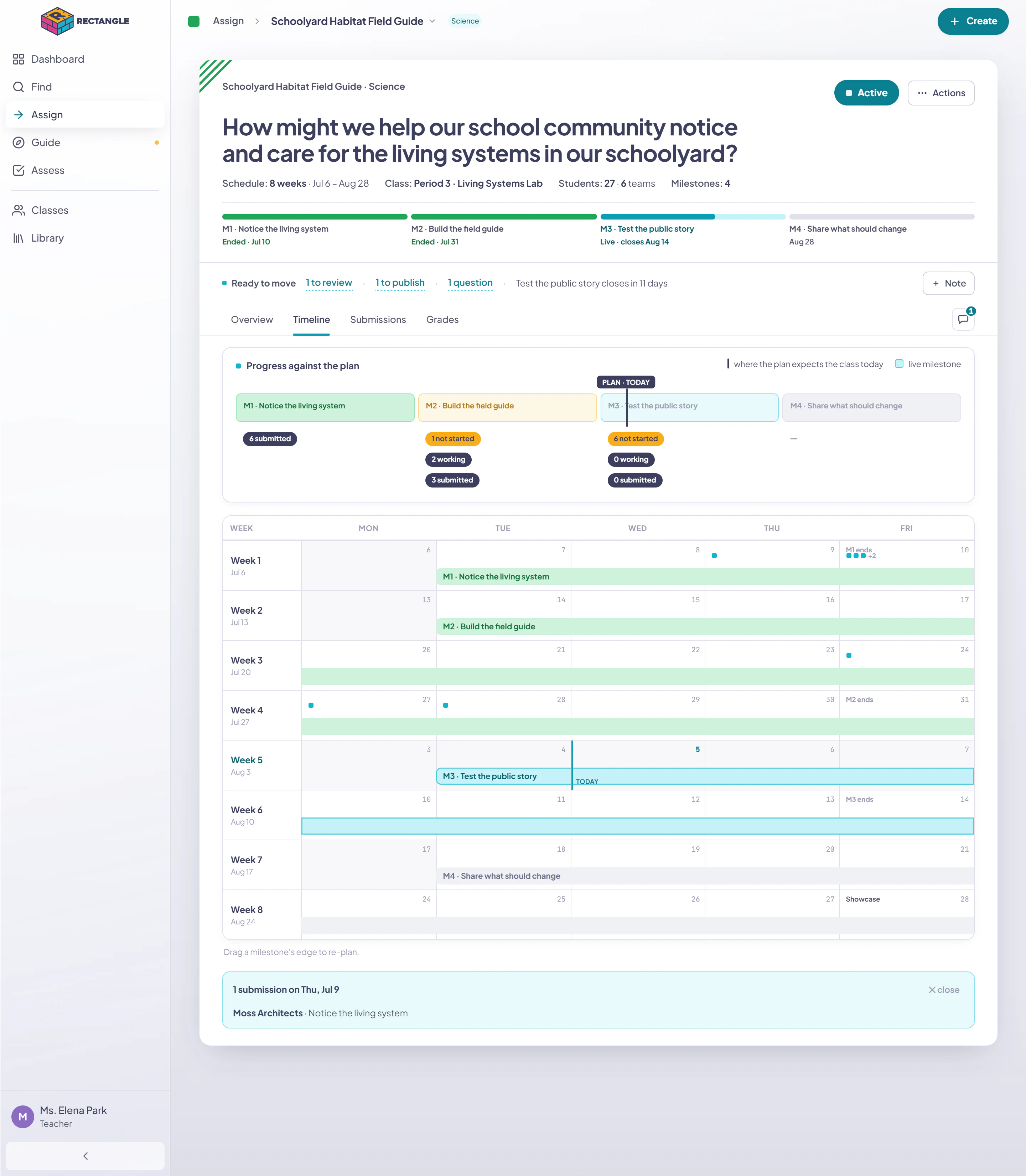

Section titled “Read the calendar”The week grid shows planned milestone spans and submission waypoints on their actual dates. Select a waypoint to see who submitted which milestone that day.
The day detail remains inside the surrounding calendar, so a submission is not mistaken for the plan’s current boundary.
Keep the signals separate
Section titled “Keep the signals separate”- Pace describes progress through the project structure.
- Calendar describes when the plan and recorded events occur.
- Overview describes current work state by team or milestone.
- Submissions is where you review the evidence itself.
When the calendar plan needs to change, use the milestone edge or Adjust dates. Rectangle will preview the downstream schedule before applying it.
